Wharf Capabilities Piping

Wharf Capabilities Project

Wharf Capabilities Project

CHEVRON REFINERY

Project Value: $1.1 Million

Background


In order to improve product transportation efficiency to the wharf from various locations. Chevron contracted Goebel Construction to modify its piping to improve efficiency.

Scope


  • Pipe Prefabrication
  • Pipe Support
  • Line Resize
  • Addition of Thermal Reliefs
  • Pipe Demo
  • Pressure Release Device (PRD)
  • Supports
  • QA/QC Tracking
  • Tie-ins to existing lines
  • Valve Changes at pump station

Project Highlights

  • 156 Welds
  • 600 ft of pipe demolished
  • Utilization of pipe tugging method was safely implemented which resulted in cost savings for the client.
  • Foreman forecasted manpower needs to control costs

Challenges


  • Piping Demo Scope of work included working on a hillside with limited accessibility.
  • Multiple work-site areas with overhead powerlines
  • Scheduled outages left minimal room for error to complete the project on time.

Solutions


We collaborated with operations to map out a new pipeline combined with existing underutilized routes. The field data gathered and the proposed plan was used by engineering for the final work construction package. To save costs, we prefabricated the welds to lower the number of field welds.

Project Success


The project was completed without any reported injuries or environmental incidents for a total of 5,250 man-worked hours. Completed the project by end of the year in order to use allotted funding.

Crafts Supported


  • Pipefitters

LFSO-Crude-Flex-2

LSFO Crude Flexibility Project

LSFO Crude Flexibility Project

CHEVRON REFINERY

Project Value: $900,000

Background


With an opportunity to increase efficiency and profits, Goebel Construction was tasked by Chevron with the 30 LSFO Crude Flexibility Project. With the new LSFO line, a wider range of products could be moved efficiently to different Locations.

Scope


  • Earth Moving
  • Hydrotesting
  • Demo of Pipes & Supports
  • Piping Prefabrication
  • Pipe Support
  • Masonry
  • Hot Taps
  • Mechanical Pipe Install

Project Highlights

  • All excavation completed by hand
  • 76 total welds
  • Foreman forecasted manpower needs to help control project costs
  • Pipe prefabrication reduced the number of field welds thus reducing costs
  • Coordinated line outages to complete welding of three 12” Hot taps

Challenges


  • The project required excavation through bedrock material.
  • The site did not allow access to heavy equipment.
  • Hot taps located in areas with limited accessibility require coordinating with multiple contractors.

Solutions


In collaboration with operations management, we were able to generate a new piping and structural support route. The planned route to different locations would open the flexibility of their crude system. The field isometrics gathered during field walks were used by engineering in the final work construction package.

Project Success


Goebel Construction completed the project under budget and a total of 3,850 safely worked man hours. Ensured the project was completed before the end of the year so allocated funding could be utilized. The success and information gathered from the LSFO project led to the wharf capabilities project.

Crafts Supported


  • Pipefitters
  • Carpenters
  • Laborers

Chevron-Support-2

Chevron Refinery Support Team

Chevron Refinery Support Team

CHEVRON REFINERY

Project Value: $1.6 Million

Background


Due to Major Turnaround and other events requiring a multitude of Chevron personnel. The Chevron Refinery required a support team at the boiler shop to backfill the maintenance projects around the refinery.

Scope


  • Direct Communication with Rep to devise safe and efficient work plans
  • Field Welding + Installation of Spools
  • Wide variety of piping classes used
  • Daily communication with Reps
  • Daily QA/QC doc submittals
  • Variety of SMAW, GTAW, alloy, structural, and specialty weld procedures
  • Field Verification and Work with DED for changes.
  • Pipe and Structure Prefab

Project Highlights

  • Team of problem solvers in order to complete projects in a timely manner
  • Projects included hot taps, steam systems and fresh air jobs
  • Projects could change daily

Challenges


The support team is tasked with completing projects that could change daily. Because of the scope and timeframe of projects, there is limited time to plan. When planning, we must consider the skillsets required to complete the assigned tasks.

Solutions


Effective communication was crucial for the successful completion of tasks safely and on time. It was important for shop representatives, Goebel Construction management, and the field crew to collaborate and understand the tasks to be completed. As well as the available resources, such as the manpower, to ensure the necessary skillset was available. By having a clear understanding of the project, we were able to plan accordingly to ensure that everything was completed efficiently.

Project Success


Owing to the success of management and the field crew’s ability to showcase a broad range of skills to complete tasks. The 4–6-week project got extended to 6 months. By the completion of the project, there was a total of 9,403 safely worked man-hours.

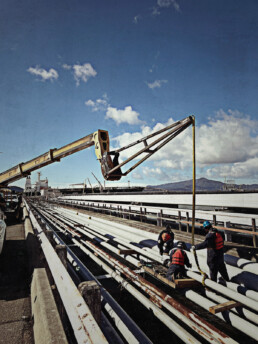

Long Wharf Sanitary Sewer Crane

Long Wharf Sanitary Sewer Replacement

Long Wharf Sanitary Sewer Replacement

CHEVRON REFINERY

Project Value: $4.6 Million

Background


The existing sewer system was at the end of service (EOS). Requested by client, Chevron, to develop and execute a replacement plan.

Scope


  •  Demolish the existing 7500LF carbon steel piping system which included:
      • Complete system flush with fresh water
      • Insolation, drain down, and blinding
      • Saw cut and removal of piping
  • Installation of 3 new septic tanks and pumps which included:
      • Vendor fabrication
      • Pre-engineered support system
  • Fabrication and installation of a new 7500LF carbon steel piping system which included:
      • 1000+ welds that required 100% NDE
      • 75+ tie-ins into the existing facilities
      • 75+ suspended work platforms
      • Hand rigging
      • Crane and rigging
      • Structural steel modifications and installation
  • Provided all QAQC which includes:
      • Welder Qualification
      • Material MTR’s
      • 100% NDE
      • Weld mapping
      • Strength test of all piping systems
      • Flange torque and reports
      • As-built drawings
  • Provide all management, field supervision, labor, equipment, and materials.

Project Highlights

  • Construction was completed without one environmental incident.
  • Client requested and relied on GCI’s construction and engineering capabilities to successfully complete this project.

Challenges & Solutions


  • Entire project was over water. Nothing in our construction process could enter the bay.
      • GCI developed and executed a site-specific plan to meet this requirement.
      • Plan was executed 100% successfully.
  • All flanged connections required double containment.
      • GCI developed the containment system.
      • System showed a project cost saving of $250,000
  • Three new septic tanks/pumps were required for this project.
      • GCI developed the installation location and pre-engineered support system.
  • Work had to be planned and completed in conjunction with a fully operational wharf with heavy ship traffic.

Project Success


Logistically difficult project that was completed on time without any disruptions to product deliveries or environment.


RLOP crane

RLOP Turnaround

RLOP Turnaround

CHEVRON REFINERY

Background


During the 4th Quarter of 2022, Goebel Construction executed a Turnaround Event on Chevron’s Richmond’s Lube Oil Plant (RLOP) unit. Considered a Major Turnaround Event by the client, they entrusted Goebel to provide numerous services including mechanical piping, civil construction, and labor support.

Crafts Supported

  • Pipefitters
  • Laborers
  • QC Technician
  • Operators

Services Performed


  • Pipe Replacement
  • Temporary Piping
  • Foundation Anchor Bolt Replacement
  • Sour Water Piping Replacement
  • Pipe Repair
  • Grouting of Column and Flare Bases
  • Valve Changes
  • Relief Blowdown Piping
  • Pipe Detailing
  • Safety Attendants
  • PRD Replacement
  • Pipe Prefabrication
  • Labor Ground Support
  • Condensate Pipe Replacement
  • Paving
  • Earthmoving

FCC Project

FCC Turnaround Project

FCC Turnaround Project

CHEVRON REFINERY

Background


During the 4th Quarter of 2020, Goebel Construction executed a Turnaround Event on Chevron’s Fluid Catalytic Cracking (FCC) unit. Considered a Major Turnaround Event by the client, they entrusted Goebel to provide numerous services including mechanical piping, civil construction, and labor support.

Project Highlights

  • Started and completed during the height of the pandemic
  • Pre-turnaround activities: 50,000 hrs.
  • Turnaround man-hours, during execution (60-day duration): 100,000 hrs.
  • Total man-hours: 150,000
  • 465 weld count
  • 706 bolt ups
  • 7,000 tons earth moved
  • 0 recordable injuries
  • Project came in under budget and ahead of schedule

Scope


  • Detailing and prefabrication of process piping spools
  • Temporary piping installation and removal
  • Isolation and blinding of unit
  • Piping removal and replacement
  • Valve changes
  • PRD replacement
  • Flare piping removal and re-installation
  • Cooling tower cleanup
  • Import and removal of 3,500 tons of fill for temporary crane pad construction
  • Anchor bolt and foundation replacement
  • Grout column and flare bases
  • Structural steel installation and repair
  • Labor ground support
  • Safety attendants (fire watch/hole watch)

Crafts Supported


  • Pipefitters
  • Laborers
  • Operators
  • Iron Workers

CVX/EBMUD RO Plant

CVX/EBMUD RO Plant

CHEVRON REFINERY

Project Value: $4 Million

Scope


Expand plant to receive and process EBMUD reverse osmosis water.

Challenge

We needed to install 3,500LF of 316 stainless steel pipe from EBMUD to Chevron’s treatment facility. This work included site excavation and grading, concrete foundations, installation of pumps and filter, pipe racks and critical tie-ins during the plant shutdown.

Solution


Before construction began, we noticed the project was designed with a standard sewer system. We helped redesign and construct a sewer system that met process refinery requirements.

Project Success


We completed the project on time, under budget and 100% injury-free. Plants were able to receive, treat and use most all of the Richmond plant outfall waste, which reduced or eliminated discharge to the San Francisco bay.


Sulfur Recovery Loading Rack

Sulfur Recovery Loading Rack

CHEVRON REFINERY

Project Value: $5 Million

Scope


Civil construction of eight new concrete foundations and one loading rack foundation, to facilitate erection of structural steel and installation of mechanical piping to support the new loading rack and its necessary pumps, structures and amenities.

  • Project Specialties
  • Pile Driving
  • Excavation
  • Grading
  • Underground
  • Electrical
  • Masonry
  • Paving
  • Structural Steel
  • Mechanical Piping

Challenge

Maintaining unimpeded access to the current loading rack while completing civil/structural, mechanical and piping installation for the replacement sulfur truck loading rack to increase the truck loading capacity and improve safety.

Solution


By coordinating with operations and traffic plans during the 12+ month project to off-haul sulfur at the existing loading rack, we assisted in constructing the new loading rack without impeding necessary truck traffic.

Project Success


The new rack and its necessary foundations were safely completed.
